This crane’s Chicago business will be renovating the Thompson Center

You can check one of those pending tower cranes off the waiting list. Clark Construction & team began erecting the tower crane at the Thompson Center this weekend. They got decent weather for late-January to do it, so hopefully there will be no setbacks through Sunday to getting setup complete.

This is the only tower crane operating in The Loop right now, and one of only six throughout the city. It joins Streeterville’s 400 Lake Shore in the downtown area, and four South Side cranes, including Project H.O.O.D. in Woodlawn, the Obama Presidential Center in Jackson Park, and two at the AbbVie Foundation Cancer Pavilion in Hyde Park. It was permitted on July 03, 2024, with word on the site to expect assembly around Labor Day. That, of course, was four months ago, so we’ve been waiting on this one.

The Thompson Center, as I’m sure you know by now, is being renovated for Google. It has been completely stripped of its exterior skin, to be replaced by a much more energy-efficient glazing. If the building looks like a shell of its former self, that’s because it is. Google hopes to have employees move into the 17-story building mid-2026.

Enjoying the photos? Metra and CTA rides (and Amtrak trains to Milwaukee), Zipcars, Divvy Bikes, camera lenses, domain fees, snacks & energy drinks, and comfortable walking shoes add up. You can help offset expenses by making a greatly-appreciated donation to Building Up Chicago.

Chicago enters December 2024 with seven tower cranes in the air

Chicago’s tower crane count as we entered Fall 2024 was seven. It remains at seven as we enter meteorological winter. None have been erected, none taken down. The only change from September’s roll call is a permit for a luffing crane for the Thompson Center renovation. But that one, and the crane permitted at Grand Crossing (1100 West Grand) have yet to make their debuts.

410 North Elizabeth crane permit.

There is one *pending* tower crane permit on the books, for the residential building at 410 North Elizabeth. Fingers crossed that the caisson permit is issued any day and construction can get started. There are four pending permits total for that one.

Let’s look at some statistics, since seven tower cranes aren’t all that difficult to break down. This is your unofficially Official December 2024 Chicago Tower Crane Survey:

What are they building?

Residential – 3 (400 Lake Shore, 1723 South Michigan, 220 North Ada — 1723 and 220 are both topped out. Those cranes will disappear soon)
Health Care – 2 (Both at the AbbVie Foundation Cancer Pavilion at 5644 South Drexel)
Cultural – The Obama Presidential Center Museum Tower
Community – Project H.O.O.D. (6623 South MLK Drive)

Who’s operating them?

220 North Ada – Clayco, Adjustable Concrete
400 Lake Shore – LR Contracting, BOWA Construction, Goebel Forming
1723 South Michigan – Brandts Build, Goebel Forming
Obama Center – The Concrete Collective
Project H.O.O.D – LR Contracting, Goebel Forming
Abbvie Foundation Cancer Pavilion – Turner Construction, Adjustable Concrete

Where are they?

Woodlawn – 2 (Obama Center Museum Tower, Project H.O.O.D — Woodlawn is the Community Area; Jackson Park is the neighborhood for the Obama Center)
Hyde Park – 2 (Both at the AbbVie Foundation Cancer Pavilion)
South Loop – 1 (1723 South Michigan – topped out)
West Loop – 1 (220 North Ada – topped out)
Streeterville – 1

Only five tower crane permits have been issued in 2024, including the two that haven’t been erected yet. There are a lot of projects in the works for next year; here’s hoping we can add a few more in 2025.

1723 South Michigan
1723 South Michigan, now topped out.
Project H.O.O.D., 6623 South Martin Luther King Drive
Project H.O.O.D., 6623 South Martin Luther King Drive
AbbVie Foundation Cancer Pavilion
AbbVie Foundation Cancer Pavilion, 5644 South Drexel
220 North Ada
220 North Ada, now topped out
400 Lake Shore
400 Lake Shore, 462 East North Water
The Obama Presidential Center Museum Tower
The Obama Presidential Center Museum Tower, 6001 South Stony Island

919 West Fulton drops the tower crane; 7 remain in Chicago’s skies

919 West Fulton no longer has a tower crane, having taken it down last week. Skender (who watched crane removal up close and personal in that Instagram video) topped out the building in July, so it stuck around for a bit before being lowered to the ground.

The Fulton Market District still has one tower crane in operation, at 220 North Ada. There are six others around town:

2 at UChicago Medicine in Hyde Park
Obama Presidential Center in Jackson Park
Project H.O.O.D. in Grand Crossing
1723 South Michigan in the South Loop
400 Lake Shore in Streeterville

We have one permit awaiting erection, at the Thompson Center in The Loop. I was told yesterday that should go up by the end of the month.

Craneless 919 West Fulton, photographed September 10, 2024:

Tower crane permit issued for Google’s Thompson Center renovation

Ok, it just *looks* open.

As Clark Construction continues demolition work on the Thompson Center for Google, a tower crane permit has been issued by the City of Chicago. My guess is, the crane will be installed on the Clark Street (east) side of the building, where a gaping hole in the exterior would allow tying off to the concrete core.

Google’s transformation of the Thompson Center will add the 10th crane to Chicago. We started July with nine in the air. Projects at Hyde Park Labs and The Obama Presidential Center Museum Tower have topped out, but I don’t have info on when those two cranes will be taken down.

Put the tower crane here?
Tower crane permit via Chicago Data Portal

Chicago’s newest tower crane goes to work at 1723 South Michigan

There’s a new tower crane in town, picking stuff up and setting it back down, and it’s going to send 1723 South Michigan vertical. This 12-story, 149-unit rental building is being developed by CMK Companies. Along with retail space on the ground floor, the first three levels will include 89 parking stalls.

Congratulations to Brandts Build for their first tower crane on my count. Hopefully there will be a couple more one block west when this one’s finished. Shout-out as well to Goebel Forming, the concrete contractor here.

And now, the tower crane photos:

Chicago begins June 2024 with eight tower cranes working the skies

Chicago has begun June 2024 with eight working tower cranes around the city, down one from the nine we had in May. The base has been planted at 1723 South Michigan, but the crane won’t be erected there until early June.

The South Side still rules, with five of our eight cranes. One South Side crane came down in May (at 4822 S Cottage Grove) but two North Side cranes came down (O’Hare T5 garage and Illinois Masonic.) Here’s a quick survey for June:

What Community Area are the cranes in?

3 – Hyde Park (Hyde Park Labs, UChicago Medicine X2)
2 – Woodlawn (Obama Center, Project H.O.O.D.)
2 – Near West Side (220 North Ada, 919 West Fulton)
1 – Near North Side (400 Lake Shore)

Okay, but what neighborhood?

3 – Hyde Park (Hyde Park Labs, UChicago Medicine X2)
1 – Woodlawn (Project H.O.O.D.)
1 – Jackson Park (Obama Center)
2 – Fulton Market District/West Loop (919 West Fulton, 220 North Ada)
1 – Streeterville (400 Lake Shore)

What are they building?

Cultural Facility – 1 – 6001 S Stony Island (Obama Presidential Center)
Healthcare – 2 – 5644 S Drexel X2 (UChicago Medicine Cancer Care)
Office – 1 – 217 N Sangamon (919 West Fulton)
Community Center – 1 – 6822 S MLK Drive (Project H.O.O.D,)
Life Sciences – 1 – 5201 S Harper (Hyde Park Labs)
Residential – 2 – 220 North Ada, 462 N Water (400 Lake Shore)

Cranes added in May:

220 North Ada
462 N Water Street (400 Lake Shore)

Cranes taken down in May:

900 West Nelson (Illinois Masonic)
O’Hare Airport Terminal 5 parking garage
4822 S Cottage Grove (Northwestern Medicine Bronzeville)

Here are your June 2024 tower cranes, from north to south:

462 E North Water St. (400 Lake Shore)
217 N Sangamon St (919 West Fulton)
220 North Ada
5201 S Harper Ave (Hyde Park Labs)
5644 S Drexel Ave (UChicago Medicine)
6001 S Stony Island Ave (Obama Presidential Center)
6623 S Dr Martin Luther King Dr (Project H.O.O.D.)
Partial credit for the stub at 1723 S Michigan Ave, to be erected first week of June.

Stop The Presses! 400 Lake Shore just erected Chicago’s *11th* tower crane of May 2024

The tower crane goes up at 400 Lake Shore in Streeterville.

400 Lake Shore has erected Chicago’s 11th working tower crane for May 2024, nearly matching step-for-step the ascent of the crane over at 220 North Ada. This puts a crane in the Streeterville neighborhood to replace the recently-departed RIU Plaza and Saint Grand cranes.

That’s a big NOPE. This man will never lose his job to me.

All that activity Tuesday, but I didn’t stick around to see the tower crane roll onto the lot. I *knew* I should have packed a lunch and stayed the duration.

Raising the boom, instead of lowering it, at 400 Lake Shore.

This is the tower crane you want to see between the Chicago River and Ogden Slip, a shiny yellow Liebherr that will reflect the sun like a lighthouse. I love this crane, in this spot. Maybe they’ll double the height of 400 Lake Shore so the crane stays overtime.

1723 South Michigan gets in on the tower crane fun

The tower crane stub rises from the construction site at 1723 South Michigan in the South Loop

A tower crane base has been set at the 1723 South Michigan construction site. A long stroll down through the South Loop was timed perfectly, as it appeared the crane base was being planted in concrete Tuesday just before I got there.

Will this tower crane be erected in time to make it onto the June count? We started May with nine. The stub at 220 North Ada in the Fulton Market District and this one could get us to 11, sparing any others being taken down.

1723 South Michigan is a 12-story, 149-unit rental building being developed by CMK Companies. (They also have a couple sites a block west on South Wabash. Those should get going once the South Michigan property is well underway, if not completed.) Along with retail space on the ground floor, the first two levels will include 89 parking stalls.

Gensler is the design architect. Brandts Build is the general contractor, a company I’m adding to my tower crane count for the first time.

Permits received for 1723 South Michigan (they were issued some time ago) include:
Vertical pile — 150 of them — issued 07/11/2023
Foundation/partial superstructure — issued 08/14/2023
Full building — issued 09/05/2023

There is a permit pending for the tower crane; as of Tuesday May 21, that permit has not shown up on the City of Chicago’s issued permits page.

Cool look at demolition of the former 1723 South Michigan via Google.
Vertical pile permit issued 07/11/2023
Foundation/superstructure permit issued 08/14/2023
Full building permit issued 09/05/2023

Chicago begins May 2024 with 9 tower cranes in the air

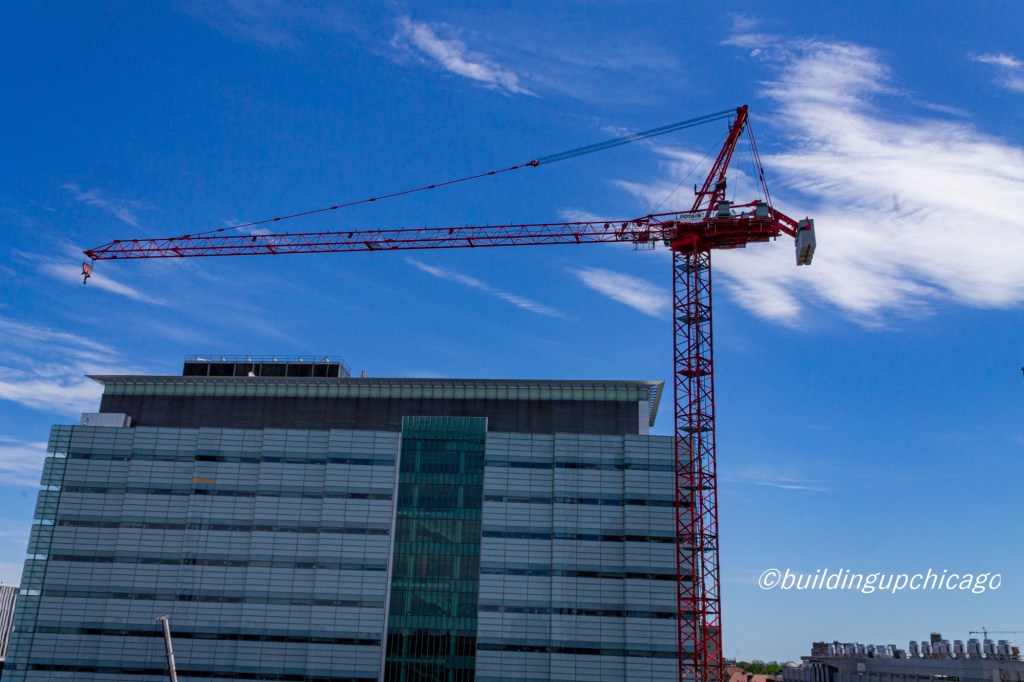

A pair of new luffers at UChicago Cancer Center in Hyde Park.

Chicago began May 2024 with 9 tower cranes operating on construction sites around the city. Nine tower cranes isn’t very many for Chicago, but it happens. The good news is, we’ve got a few on the way: at 220 North Ada (real soon), 400 Lake Shore (mid-May?), and maybe 1723 South Michigan (permit pending, but that’s just an idle, empty lot right now.)

More good news is that the Chicago Plan Commission will consider four projects at their next meeting — May 16 — that, if approved, will all require tower cranes: 700 West Chicago (multiple cranes over a multi-phase build?), 2031 North Kingsbury (355-unit apartment tower), 370 North Carpenter (29-story apartment tower), and 400 North Elizabeth (two towers, 724 total units.)

As for the nine we *do* have:

Four are building medical facilities (two at UChicago Cancer Center, one at Illinois Masonic,
and one at 4822 South Cottage Grove (Northwestern Medicine Bronzeville Outpatient Center)
One parking garage (O’Hare Terminal Five)
One Cultural Center (Obama Presidential Center)
One community center (Project H.O.O.D.)
One Life Sciences facility (Hyde Park Labs)
One office building – 919 West Fulton

Community Areas represented:
Hyde Park – 3 (Hyde Park Labs and 2 at UChicago Cancer Center)
Woodlawn – 2 (Obama Presidential Center and Project H.O.O.D.)
O’Hare – 1 (Terminal 5 Parking Garage)
Lake View – 1 (Illinois Masonic)
Near West Side – 1 (919 West Fulton)
Grand Boulevard – 1 (Northwestern Medicine Bronzeville Outpatient Center)

Here they are in pictorial form, from south to north:

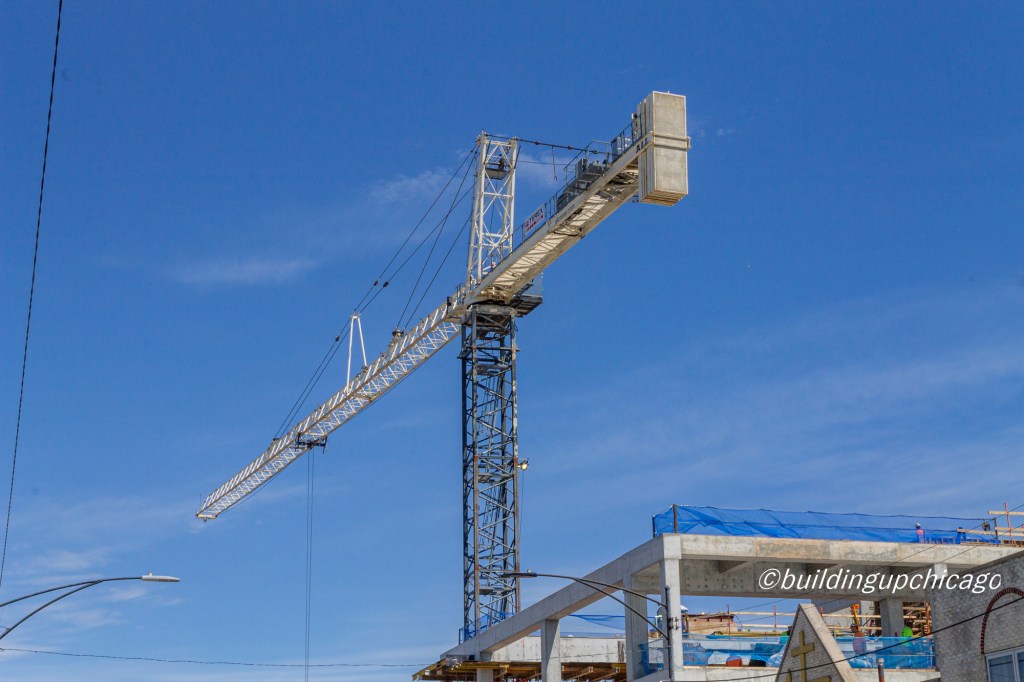

Project H.O.O.D., 6623 South Martin Luther King Jr. Boulevard

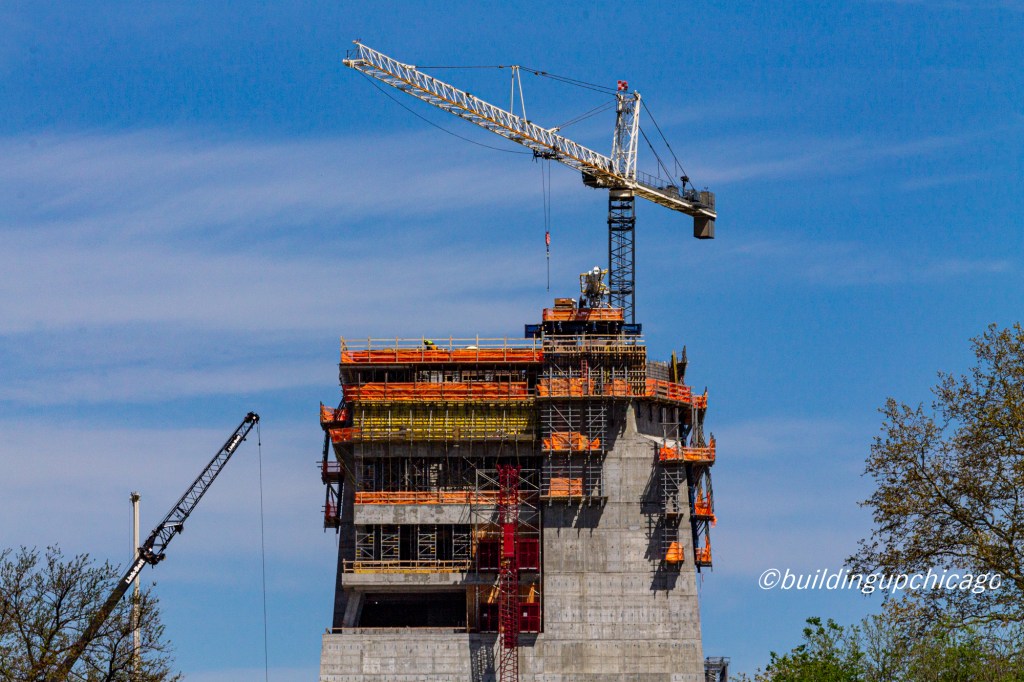

The Obama Presidential Center, 6001 South Stony Island Avenue

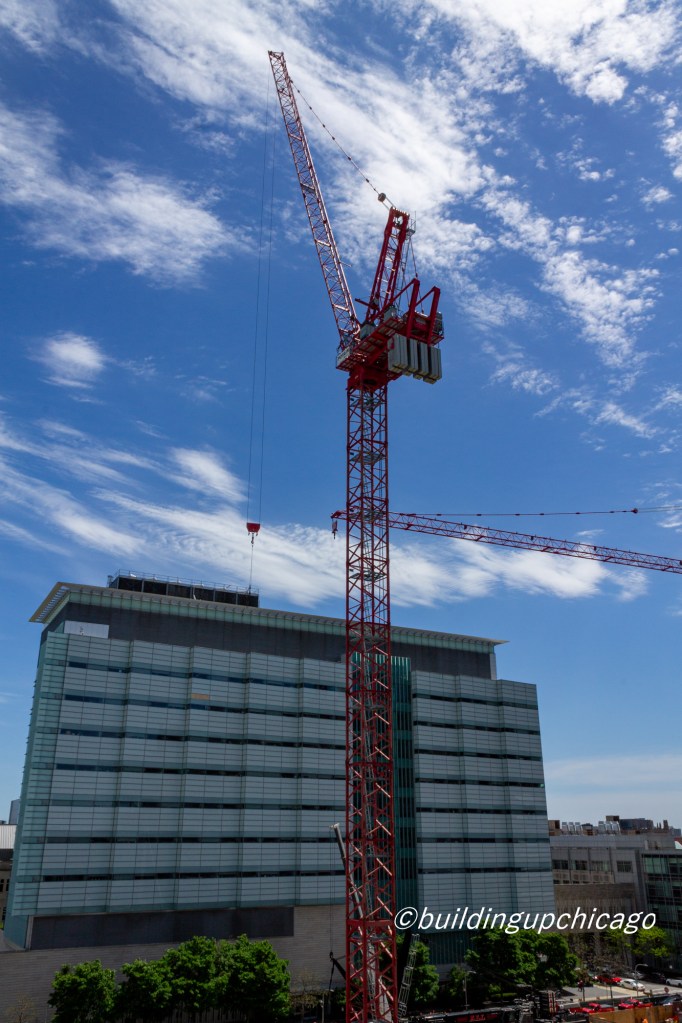

UChicago Cancer Center South Crane, 5644 South Drexel Avenue

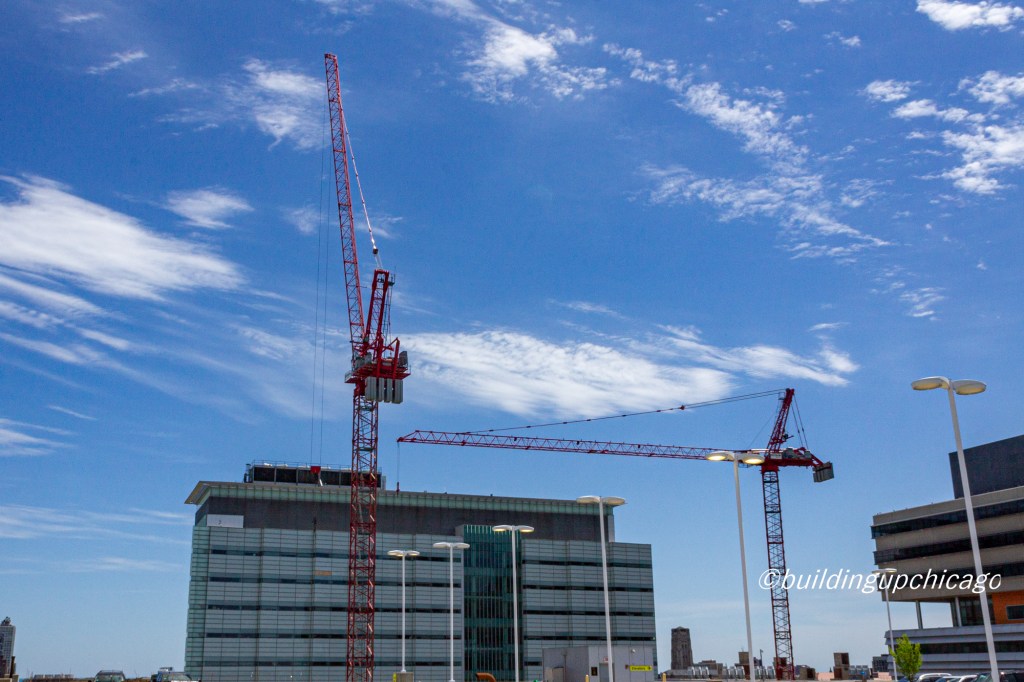

UChicago Cancer Center North Tower Crane, 5644 South Drexel Avenue

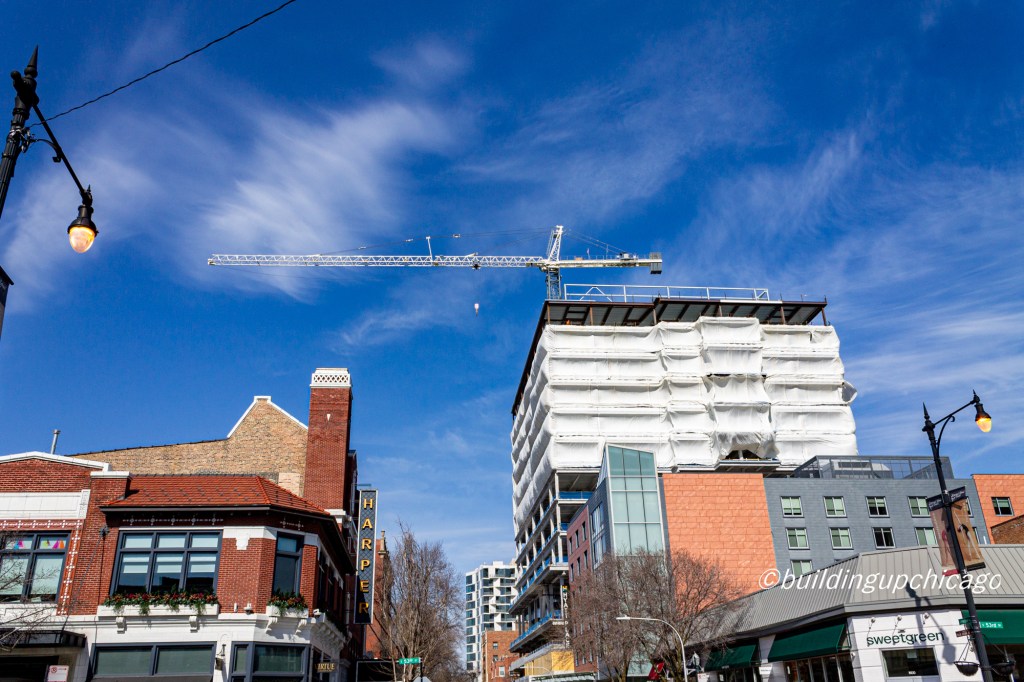

Hyde Park Labs, 5201 South Harper Avenue

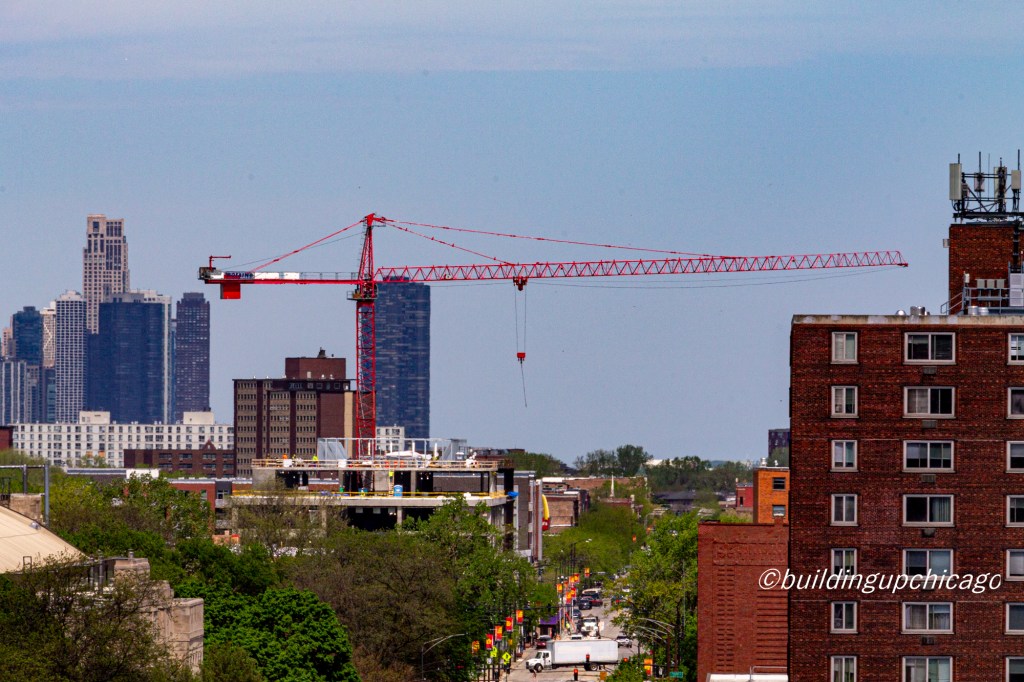

Northwestern Medicine Bronzeville Outpatient Center, 4822 South Cottage Grove Avenue

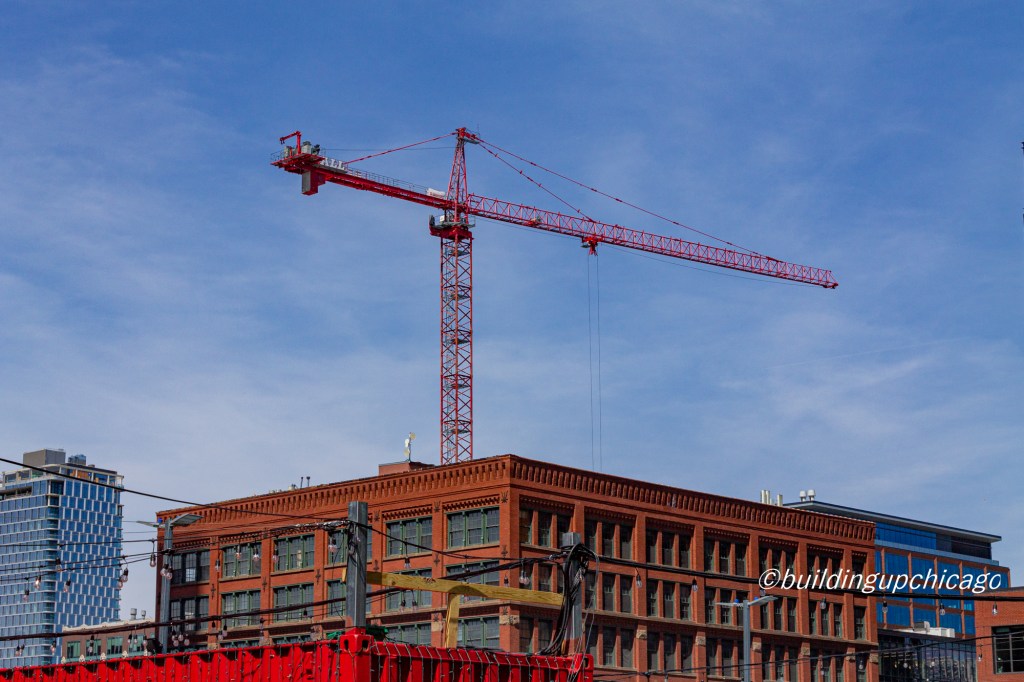

919 West Fulton (permitted as 217 North Sangamon Street)
Illinois Masonic, 900 West Nelson Street

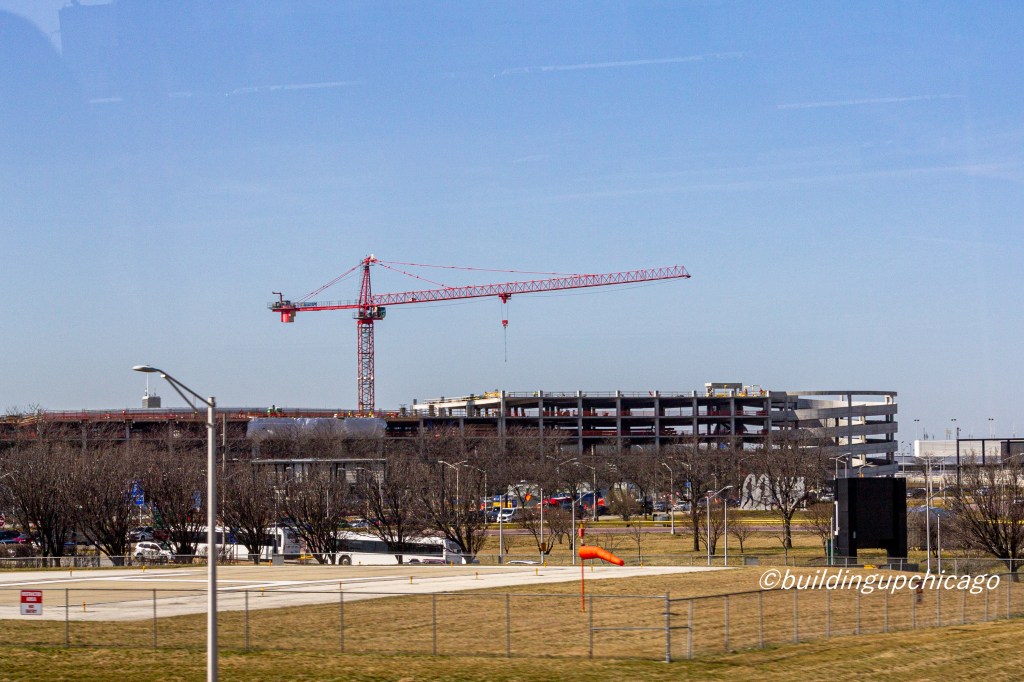

O’Hare International Airport Terminal 5 Parking Garage

Enjoying the photos? Metra and CTA rides (and Amtrak trains to Milwaukee), Zipcars, Divvy Bikes, camera lenses, domain fees, snacks & energy drinks, and comfortable walking shoes add up. You can help offset expenses by making a greatly-appreciated donation to Building Up Chicago.

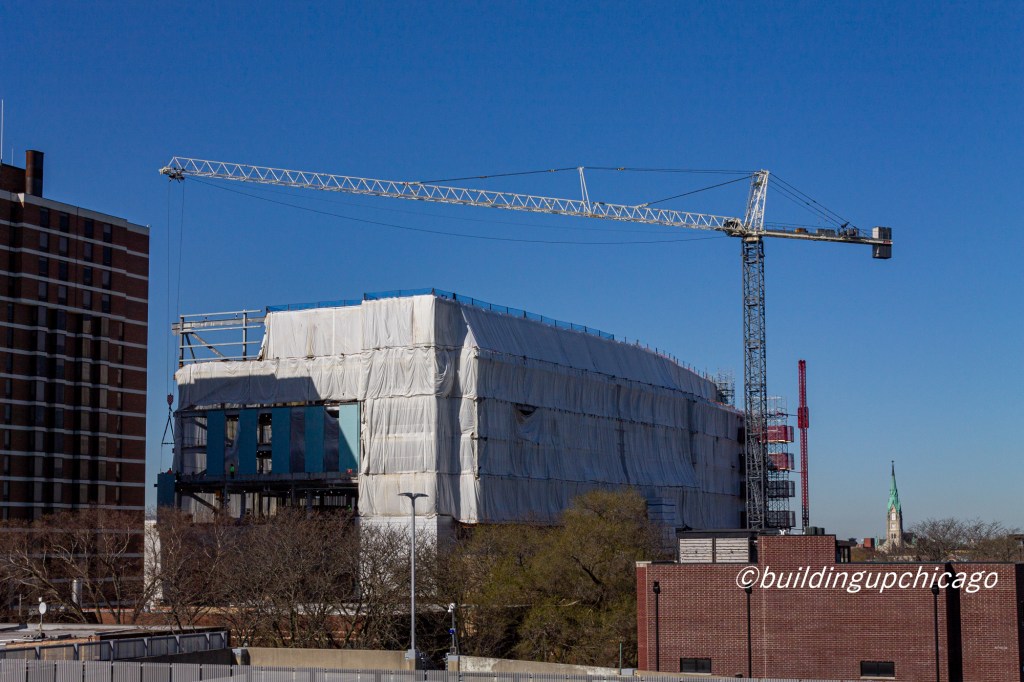

Illinois Masonic erects a tower crane

Tower crane erection at Advocate Illinois Masonic Medical Center, Lake View, Chicago
The tower crane goes up at Advocate Illinois Masonic Medical Center in Lake View.

I went to the South Loop Friday to see a new tower crane, and found an even newer one in Lake View on the way home.

Advocate Illinois Masonic Medical Center is erecting an eight-story vertical expansion (if this was a house, it would be called an addition) addressed as 900 West Nelson Street. This construction is best viewed from an outbound Brown Line train, which is where I was Friday when I snapped a couple iPhone shots of the crane going up.

Turner Construction is the general contractor. It looks from the permits issued that SmithGroup is the design architect.

Almost as many permits and floors on this one. The construction itself was permitted in three phases, while the tower crane has two permits of its own:

Phase 1 issued 1/13/2023
Phase 2 issued 1/19/2023
Phase 3 issued 6/20/2023
Tower crane slab & earth retention issued 4/12/2023
Tower crane issued 5/3/2023

The tiniest gallery of iPhone shots taken August 18:
